BoQ

General Information

The BoQ is a tender document translating relevant information on construction drawings into bill of quantities that fully describes the quality and quantities of work to be carried out by a contractor during the construction stage. It is basically a list of work items with brief detailed descriptions and firm quantities for different elements of work to be performed. In combination with the construction specification the BoQ constitutes the basis for the estimate. The BoQ commonly is structured by work categories and provides a communication context of all those parties involved in the construction process. Thereby the emphasis is to ensure all contractors working with the same level of information, that enables them to prepare tenders efficiently and accurately based on the same data.

Basic Format for Bill of Quantities

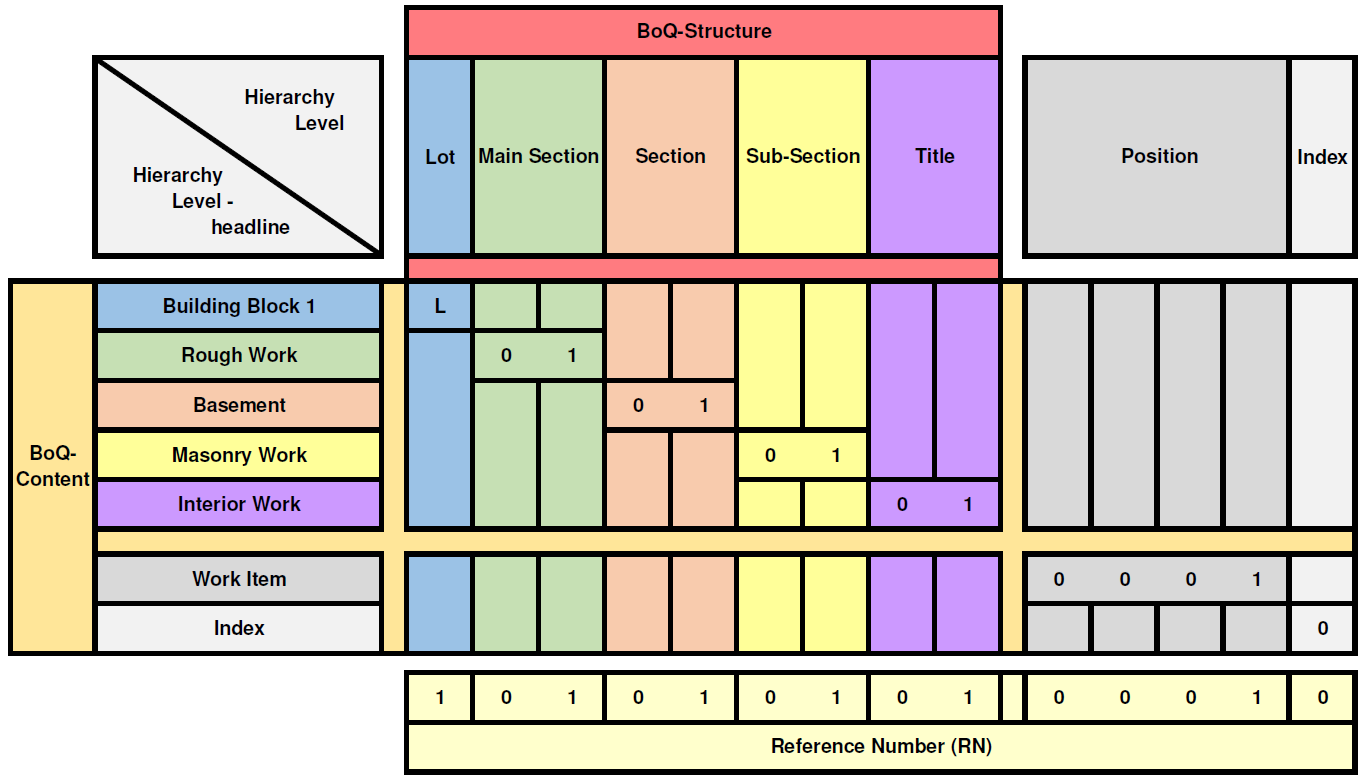

The most common format for a BoQ is an elemental structure. Elements of measured works are arranged into sequence that is clear and easy to understand. The BoQ can be abstracted easily and quickly with measurement and descriptions already grouped in the elemental format. Under each element, the order of works generally follows construction sequence e.g. site preparation works, drainage works, earth works, rough works, finish works etc.

Basic Format according to GAEB

Generally according to the GAEB-rule sets the following basic classifications are used to structure BoQs:

BoQ Elements

BoQ Root:

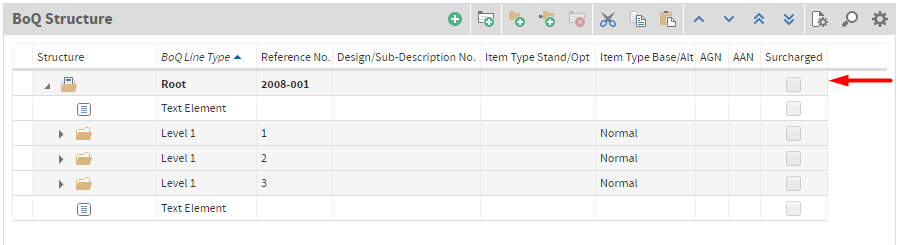

Each BoQ document has exactly one single root element. It encloses all other elements and is therefore the sole parent element to all other elements below.

Divisions:

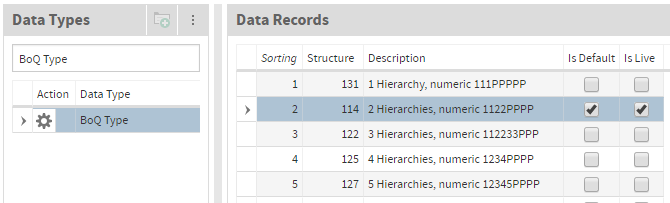

Divisions are all kind of groups, hierarchies or levels. The division is a description of a hierarchy level and hence can contain further divisions. The lowest division contains work items. The maximum number of possible divisions are determined in the BoQ settings.

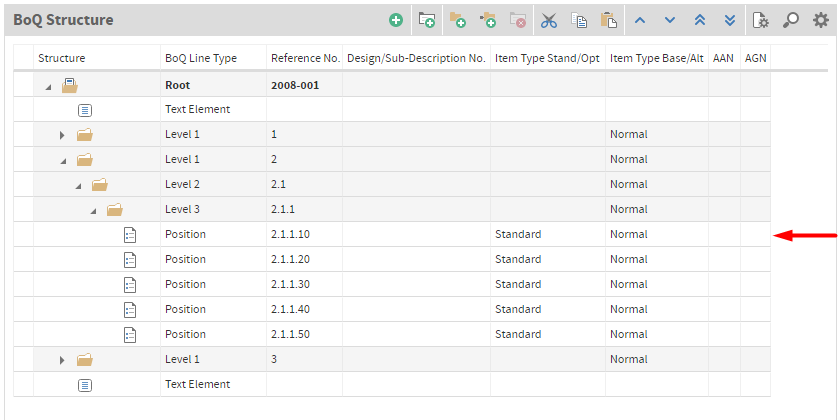

Standard Items:

The standard item (also called execution item) is a position describing services to be performed, which are executed in any case. Standard items have no special properties.

Optional Items:

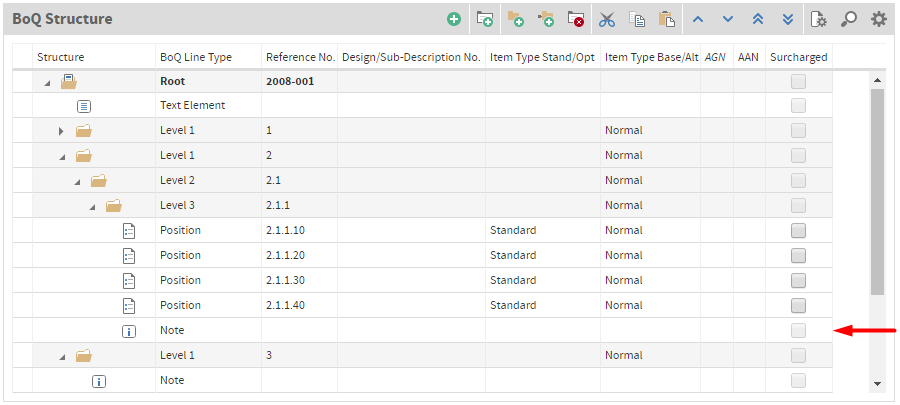

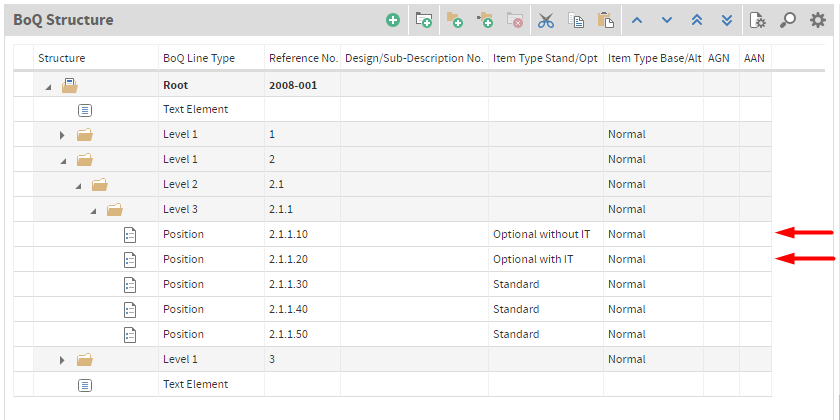

An optional item describes an item which is not yet clear whether and in what scope of service it is executed. The optional item is an item only executed on special request from client side. The item total is not displayed and is not included in the BoQ total.

Base Groups and Base Items:

The base item is an item type in the tendering of construction works. It describes a work item that probably comes to execution, but for which one or more alternatives exist. Base groups have the same behavior as base items unless whole divisions are marked as base group.

Base Group:

Base Item:

Alternative Groups and Alternative Items:

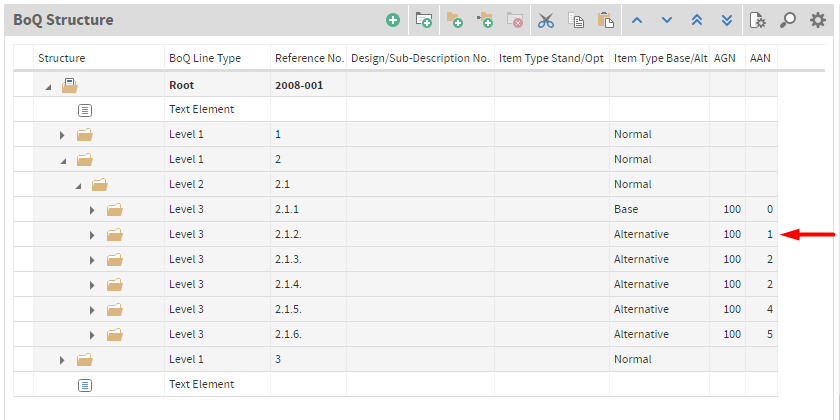

Alternative items are tendered by the customer in terms of “instead” or “optionally”. They contain alternative design variants with respect to a base item in the contract documents (BoQ) and are characterized via assignment number (assignment alternative number, AAN and assignment group number, AGN). The contractor is obliged to perform the services requested by the customer as described in these positions.
In a bidders quotation the unit rate for both the tendered base item and the alternative item must be calculated but a total is only considered for the base item.

Alternative Group:

Alternative Item:

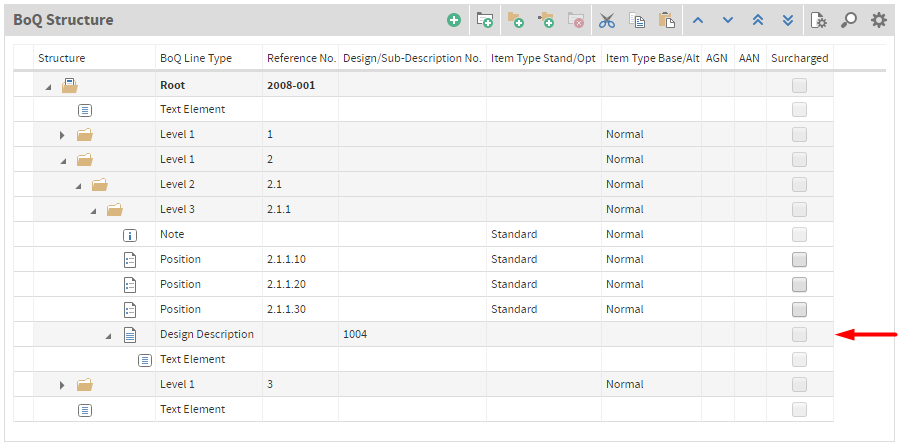

Linking Base Groups/Items and Alternative Groups/Items

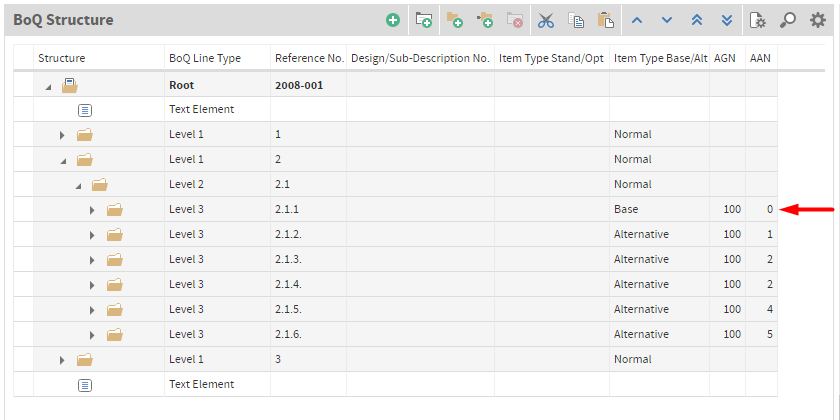

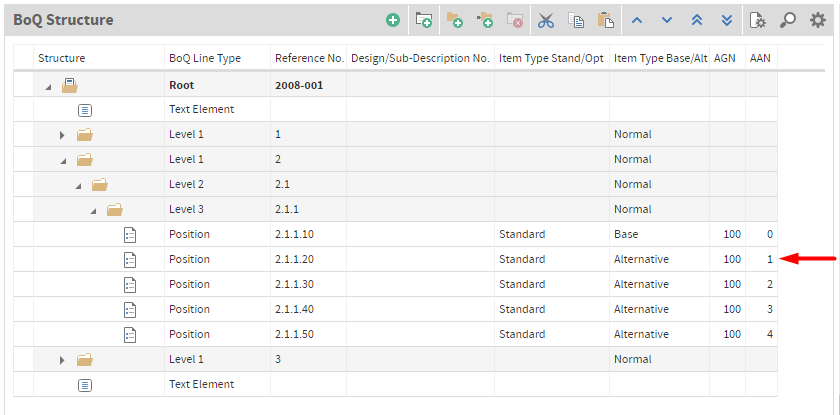

Base groups/items and alternative groups/items can be linked together via 4-digit assignment numbers. The assignment is performed by defining a 3-digit assignment number (Assignment Group Number, AGN) for a base item and the corresponding alternative items, followed by a number in the AAN field (Assignment Alternative Number, AAN).

Item Type Assignment Number Assignment Group No. (AGN) Assignment Alternative No. (AAN)

Base Item 100.0 100 0
Alternative Item 1 100.1 100 1
Alternative Item 2 100.2 100 2
Alternative Item 3 100.3 100 3

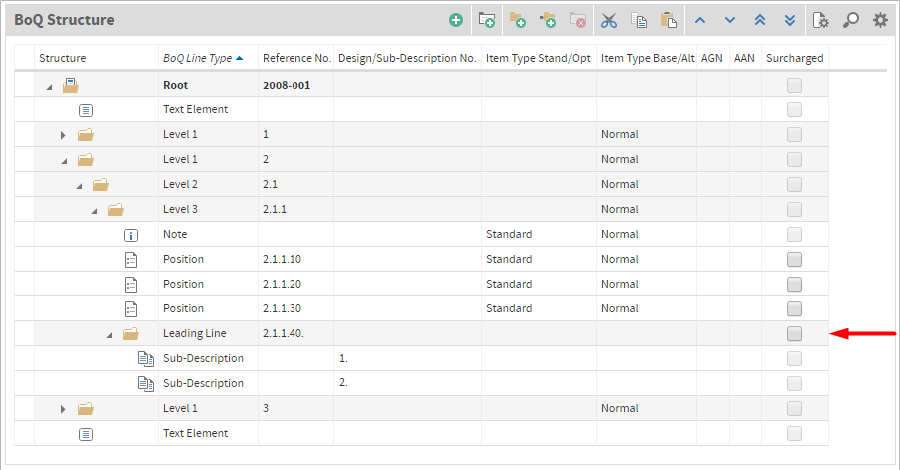

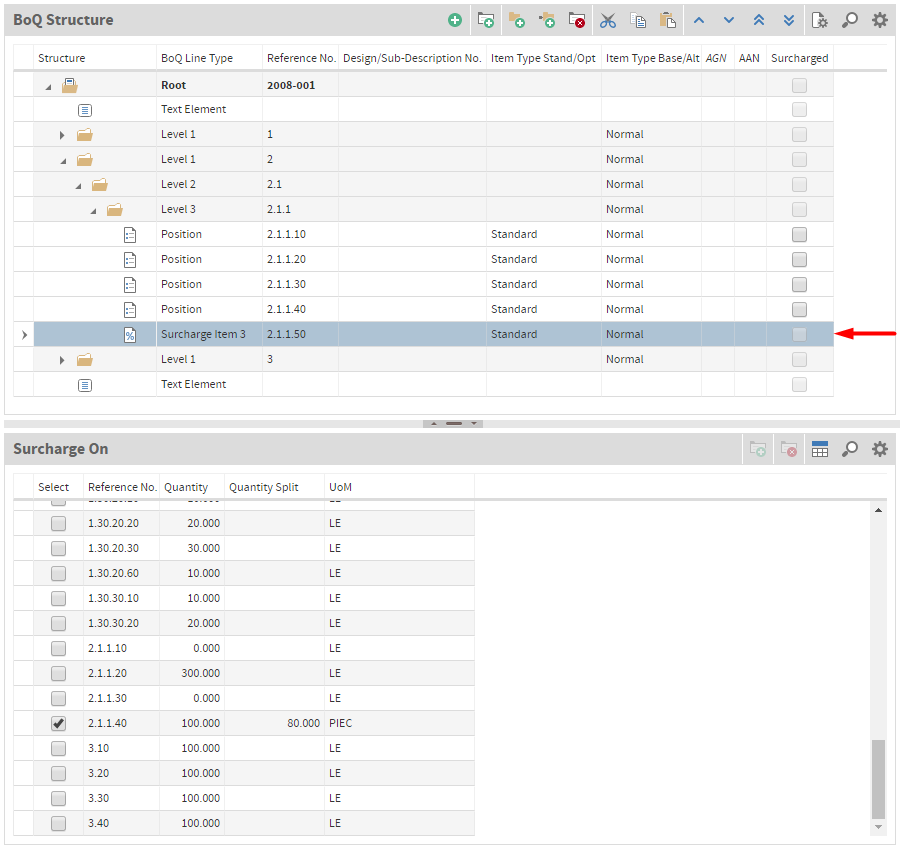

Surcharge Items:

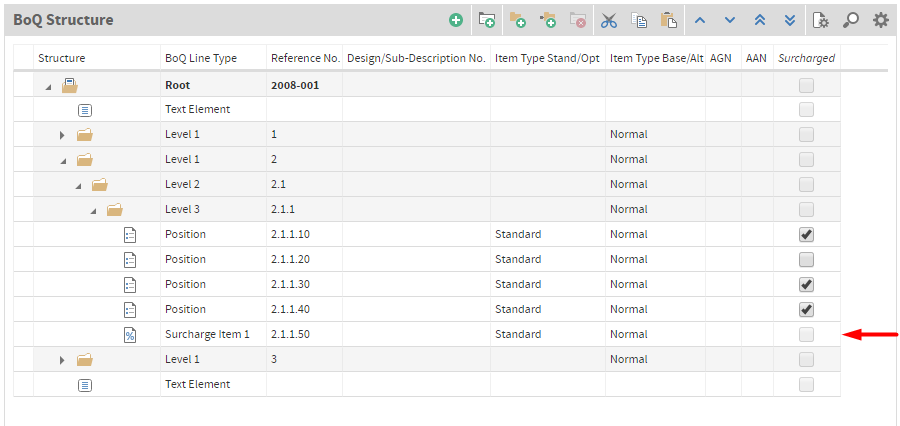

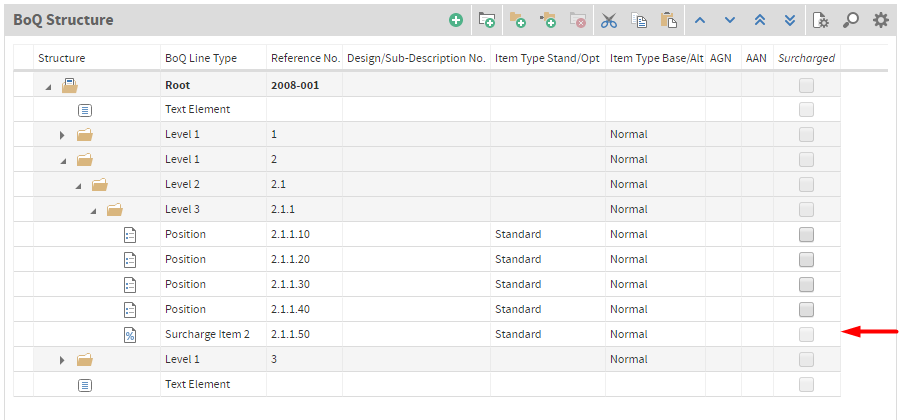

A surcharge item is a special item type within a bill of quantities. It allows a percentage surcharge on individual items, entire BoQ-areas or quantity splits of items. Surcharge items are standard items whose unit rate is the result of an item total for one or more items or split quantity for an item multiplied by a surcharge rate.

The following three surcharge item types are available in the application:

Design Descriptions:

A design description is an execution description summarizing consistent, comprehensive descriptions of a number of work items together under a single number. This number can be linked to the related work items. In conclusion the design description in combination with a supplementary text covers the entire description for each individual work item. A design description has no reference number.

Text Elements:

Text elements are free or standardized descriptions providing pre- and post-text elements. A text element can be located between root and the first record of “Level 1” (pre-element) or below the last “Level 1” record (post-element).

Notes:

Notes are free or standardized descriptions within a bill of quantities and must be considered in the pricing. Notes can refer to the entire BoQ, parts of the BoQ or individual items. Notes can be located on any BoQ level except below work items. Furthermore, notes don’t have a reference number as well as no bidder text additions.

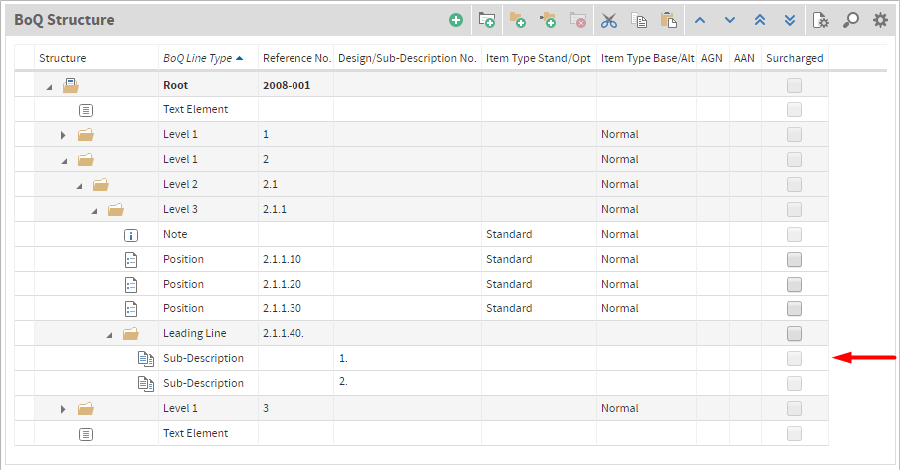

Lead-Descriptions:

For extensive specifications a work item can be composed of a lead-description and one or more sub-descriptions. The reference number as well as all the other characteristics of the standard item are assigned to the lead-description only. The related sub-descriptions are identified via the assignment of consecutive numbers, starting from 1. If necessary, sub-descriptions can additionally contain quantities but not prices.

Sub-Descriptions:

See Lead-Descriptions.

Day Work Items:

Daywork items cover all contingencies and are means by which a contractor is paid for specifically instructed work on the basis of the cost of labour, materials and plant plus a mark up for overheads and profit. It is generally used when work cannot be priced in the normal way. Unforeseen obstructions are encountered during earth works or work is instructed for which no comparative rates in a BoQ exist, are common uses cases for dayworks.

Create BoQ

There are three ways to create a BoQ. You can create a BoQ yourself as you wish or you can copy it from an existing BoQ or you can import a GAEB file.

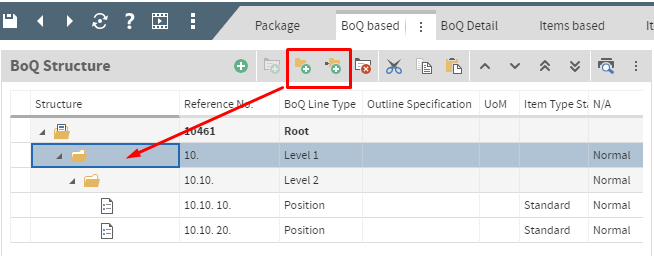

Create BoQ manually

You can create BoQ levels simply by using the following buttons.

You can use “New Record” button to create BoQ positions.

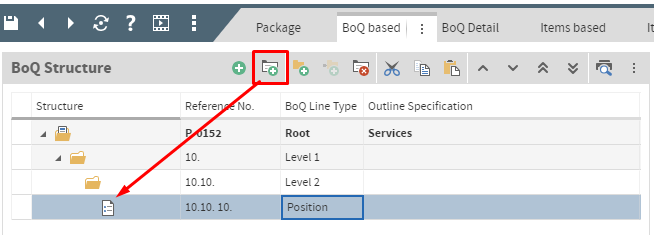

Create BoQ by copying an existing BoQ via container “Source BoQ”

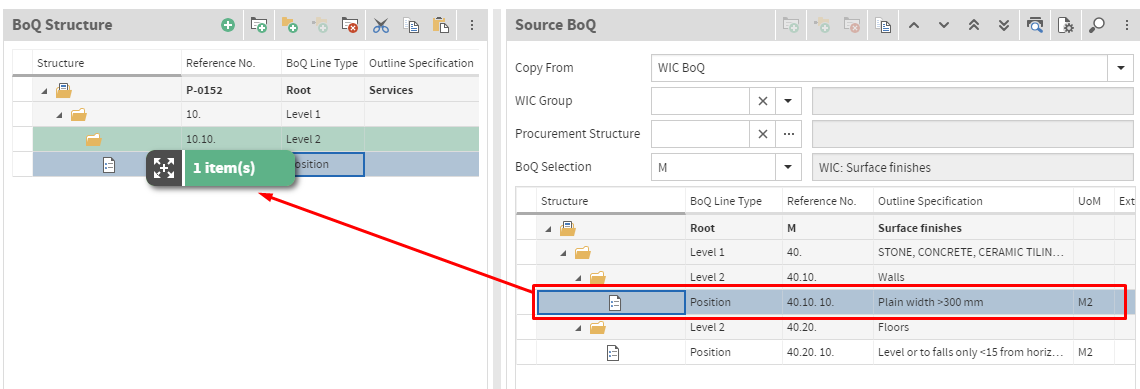

The other way to create a BoQ is to copy it from another BoQ existing in WIC, another project or another package. You can do the copy by using the container “Source BoQ” and by selecting the needed positions and pulling them over to the selected BoQ levels and release them (drag and drop). It is also possible to copy the whole BoQ.

For copying Notes inside the BoQ levels, you should press the “Ctrl” and “Alt” buttons while dropping the note. Otherwise it will be copied above the selected level or position. If you want to copy a note below the selected level or position, you should press “Ctrl” and “Shift” buttons.

Create BoQ by importing a GAEB file

You can also import a GAEB file through the Wizard in the sidebar.

Container

BoQ Structure and BoQ Details

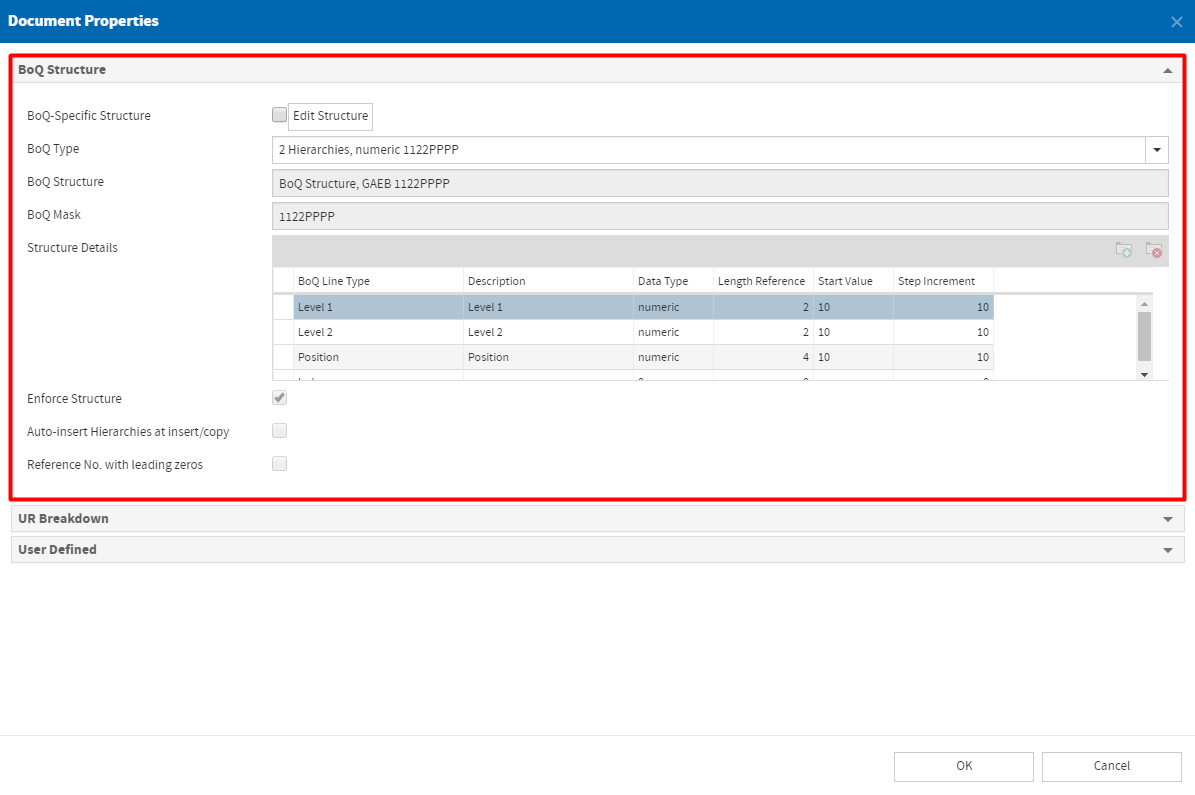

Document Properties

BoQ Structure

UR Breakdown

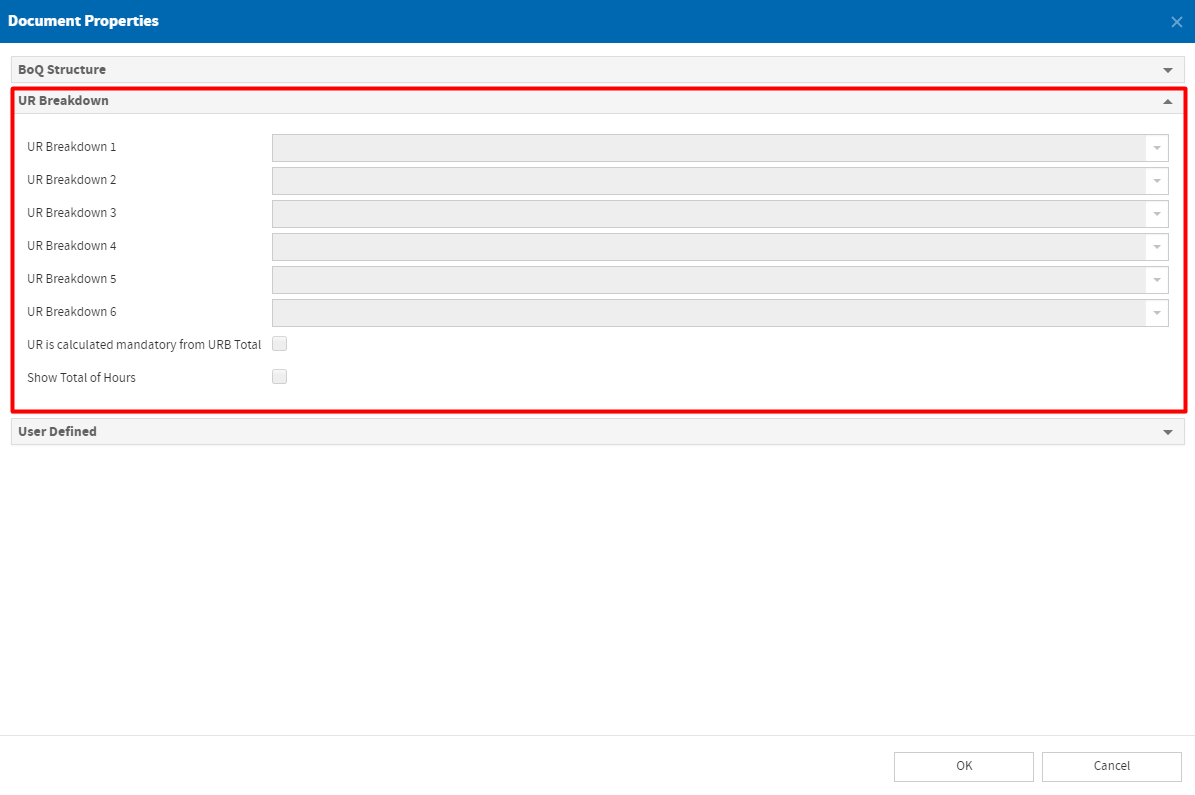

A unit rate breakdown is a decomposition of a unit rate item into its individual components. This unit rate portion already includes direct job costs (labour, material, plant, subcontractor,…) and indirect job costs (general and administration costs, general conditions, risk and profit,…). Unit rate breakdowns can be derived from estimate if work items are linked with the corresponding line items (otherwise a manual input is required).

UR is calculated mandatory from URB Total is an optional checkbox indicating whether the unit rate is calculated according to the total of all unit rate breakdowns.

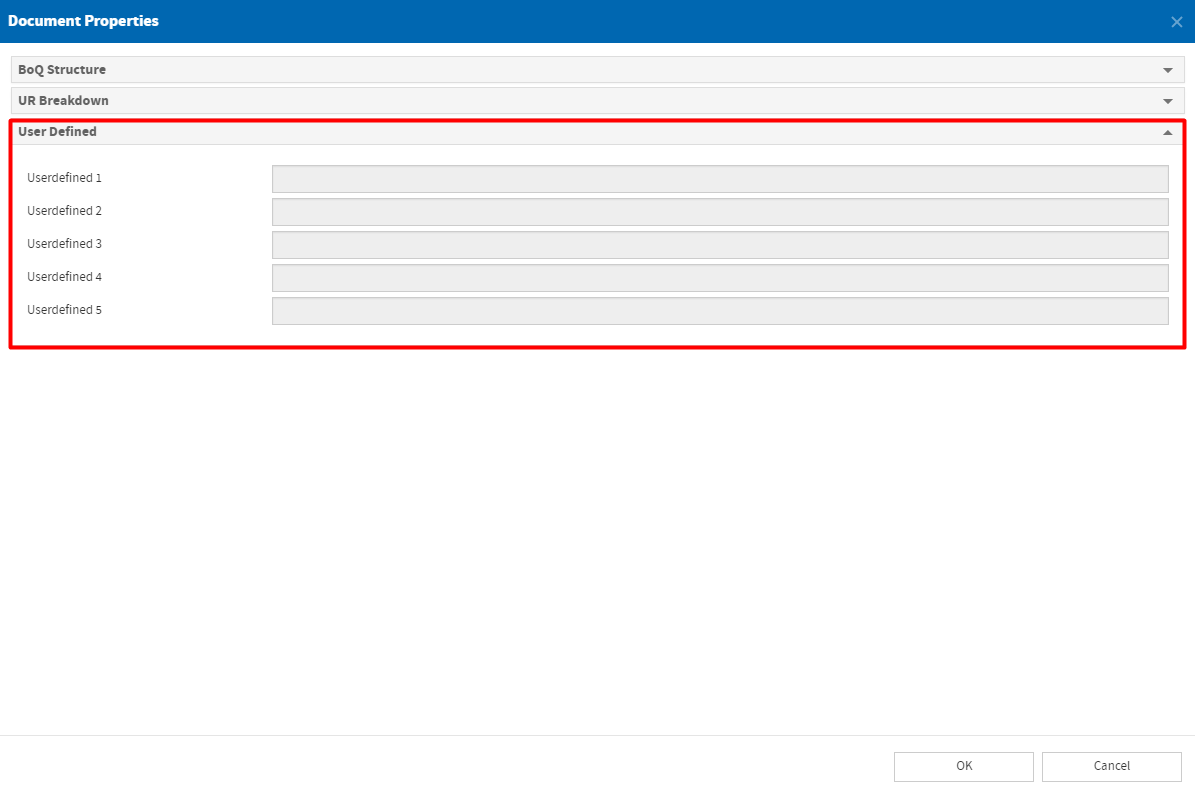

User Defined

Userdefined fields are optional text fields available for the BoQ Line Type.

Bulk Editor

The Bulk Editor is a supporting tool with which multiple records can be easily changed at once. This tool is located in the toolbar of the BoQ Structure container in Procurement modules. But it can also be used in many other containers of other modules in iTWO 4.0.

For knowing how to use it, refer to the section Scheduling.

Field Description

Basic Data

Item Type Base/Alternative

Factor

Quantity/Price

UR Breakdown

UR From/To

Discount/Lumpsum Div/BoQ

Reference to Item

Procurement Item Evaluation

Procurement Structure

Additions BoQ

Additions Estimate

Master Data Assignment

Comment Contractor

Comment Client

User Defined Texts

History

Material Lookup in BoQ

For more information about how to use “Material Lookup” Search, please refer to Material Lookup

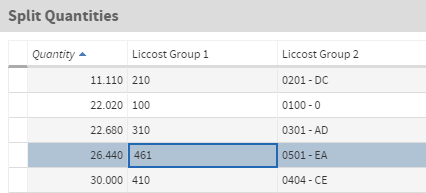

Split Quantities

The Split Quantities container is needed, when the user wants to split the quantity of his item and assign Cost Groups to each of them.

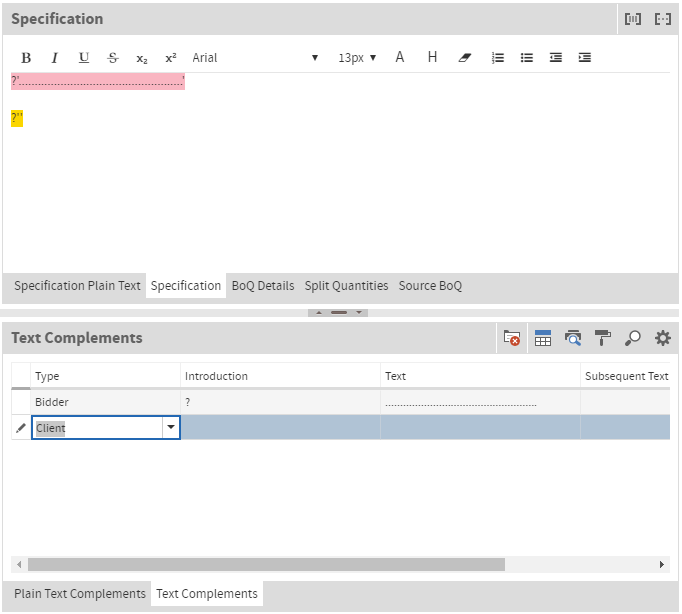

Specification Plain Text and Plain Text Complements

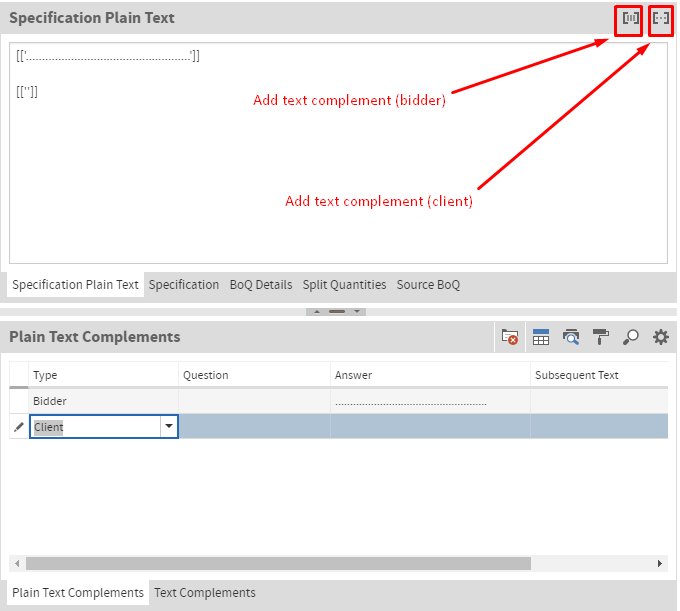

The purpose of Specification Plain Text container is to add text to each item of BoQ. The first line of the text will be taken automatically in Outline Specification. In the Specification Plain Text container it is also possible to add text complement (bidder) and text complement (client) and in the Plain Text Complements it is possible to edit them.

Specification and Text Complements

In order to add text with text formattings to each item of BoQ, the Specification container is needed.

The fonts.css file must be copied into the folder \cdn\custom\fonts. The custom fonts can be selected within this css file and the editor functions can be faded in or out in this file as well. It needs to be mentioned that these editor functions only in exceptional cases should be changed.

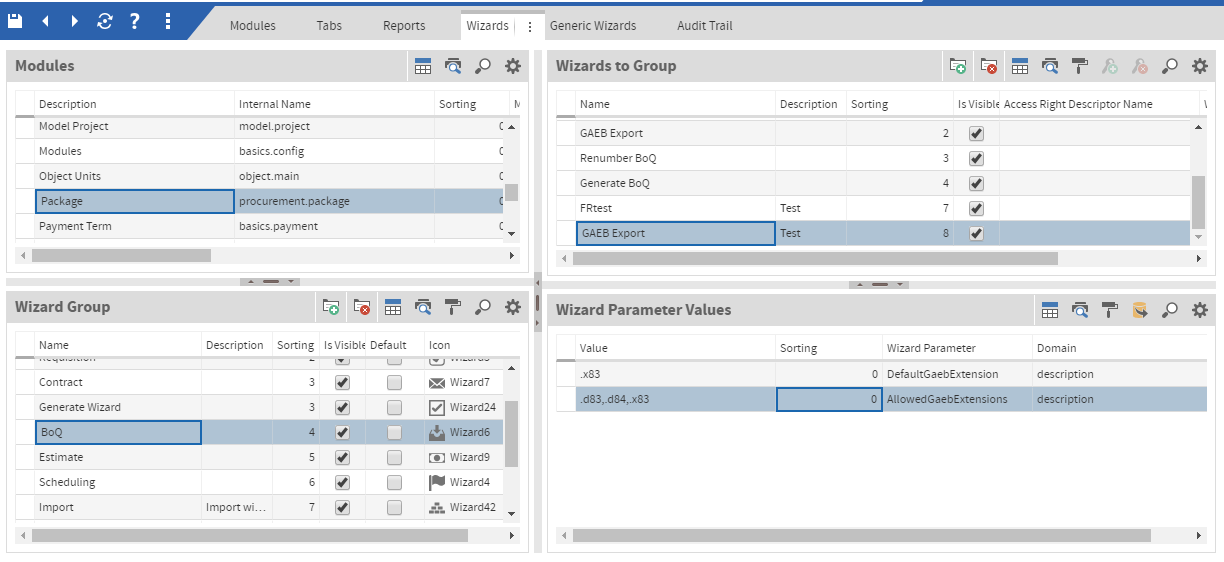

GAEB-Data Exchange

In the Modules module:

Additional it is possible to create Access Right Descriptor for each group in the wizard to allow certain users access to it.
